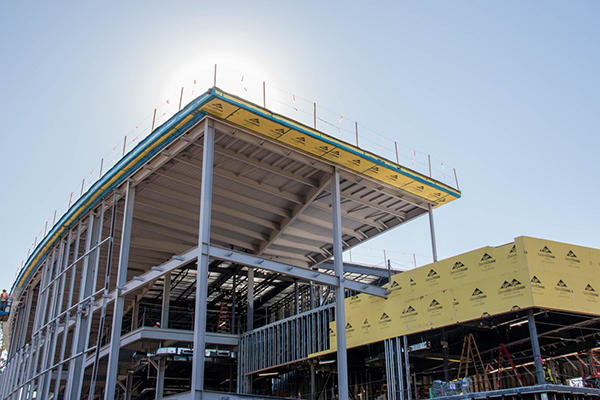

2014 Bond Updates

June 2017

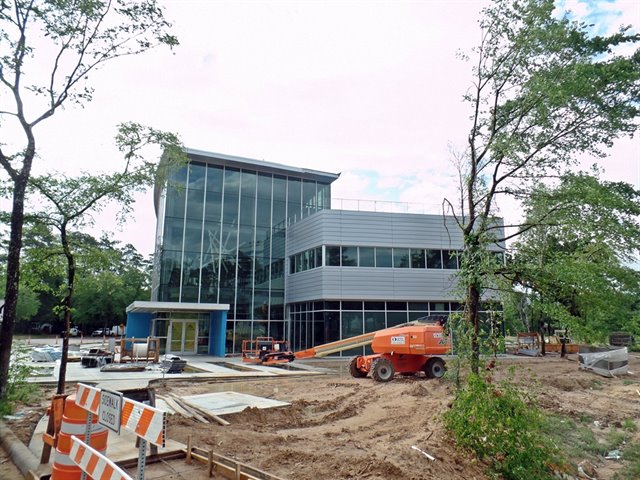

LSC-CyFair

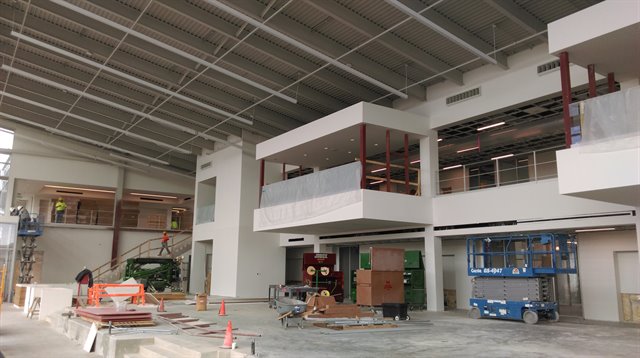

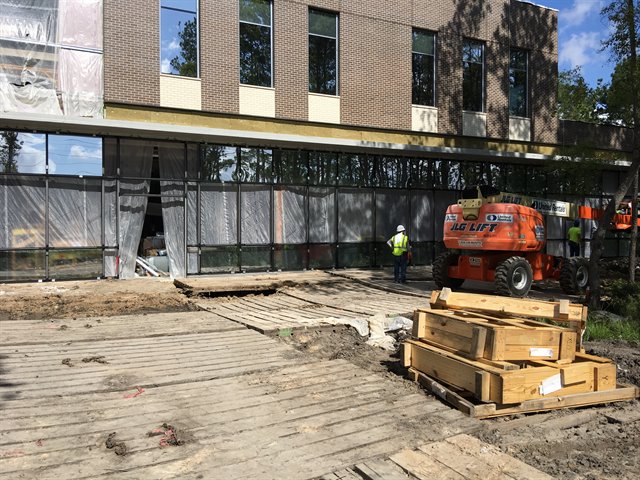

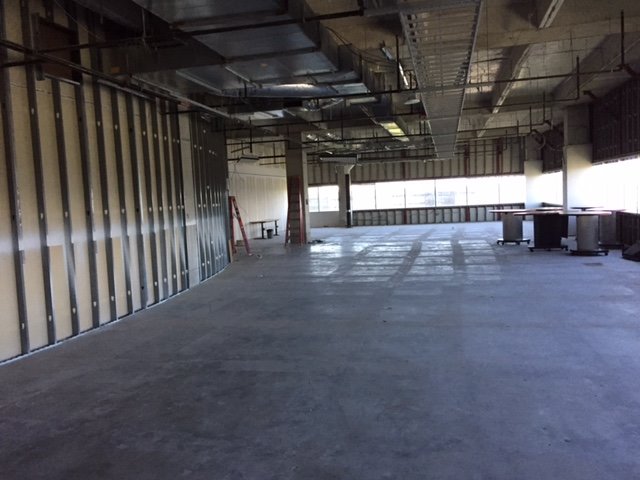

  • Instruction and Student Life Building: Final painting, door hanging, ceiling tile installation, folding partitions nearing completion in areas B and C. Security and A/V installation is progressing. Elevator trim outs are complete awaiting State inspection. Permanent gas service is due to start. Test and balancing is starting and commissioning of mechanical systems continues. Fire alarm testing is in progress. Building is close to being under air conditioning control. Movable furniture is scheduled for delivery in mid-May. Chiller water circulation is now operational to the Central Plant. Project is due to be substantially complete late June 2017.
LSC-Cy Fair Instruction and Student Life Building -- photo courtesy JLL

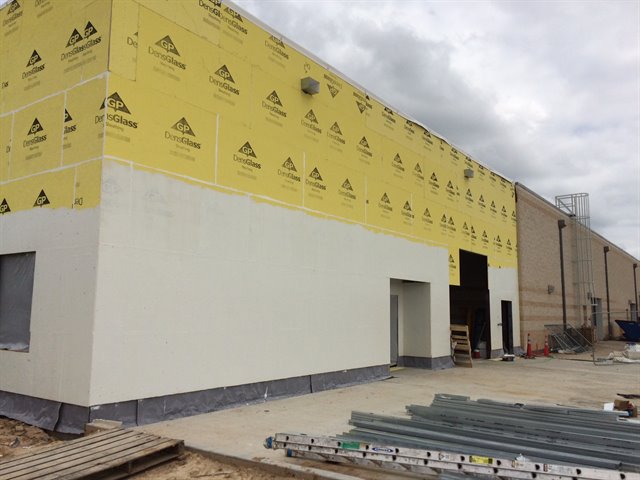

  • LSC-Cypress Center Workforce Expansion: Waterproofing of exterior walls is near completion and masonry has started. Ductwork and electrical work continues in both the building addition and renovated existing spaces. Furniture for the project is on order. Project is still tracking to be substantially complete by mid-August 2017.
  • LSC-Westway Technology Center: Project final price negotiations have been terminated with the awarded contractor. The College is in the planning process of developing another competitive bidding event for this project. A revised expected completion timeframe is forthcoming.

LSC-Kingwood

  • Student Services Center Expansion: Final exterior metal panel installation is underway. Commissioning coordination in progress. Temporary Certificate of Occupancy obtained. Furniture and equipment installation proceeding. Substantial Completion pending finish of critical items by contractor; preparation for final punch list underway. Final installation of building items arriving late but will occur at end of May.

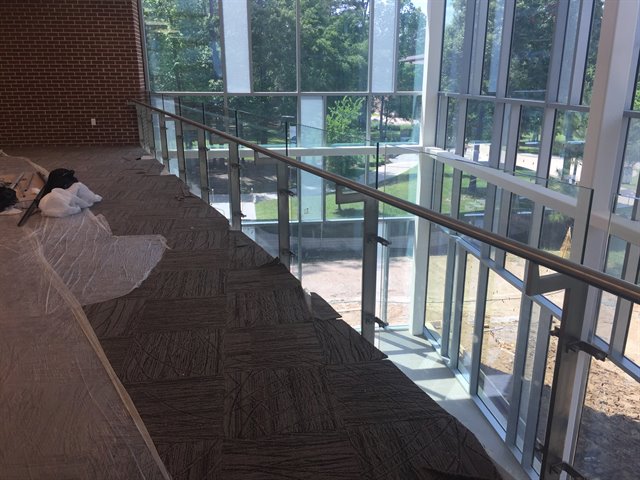

LSC-Kingwood Student Services -- photo courtsey JLL
  • Kingwood Pilot Plant: Preconstruction services complete. Final price and scope negotiations for the Guaranteed Maximum Price (“GMP”) proposal are ongoing with the awarded vendor. This facility is slated for an expected Spring 2018 opening.
  • LSC-Process Technology Center: Exterior framing, sheathing, and waterproofing is nearing completion. Roofing continues. Level 1 and Level 2 interior framing nearing completion. Wall and above-ceiling mechanical, electrical and plumbing (“MEP”) is progressing and working to incorporate functional modifications to select areas. Furniture bids reviewed and a vendor is selected. Utility service to the site is currently underway. Project is due to be substantially complete by late-August 2017.
LSC-Process Technology Center -- photo courtsey JLL

LSC-Montgomery

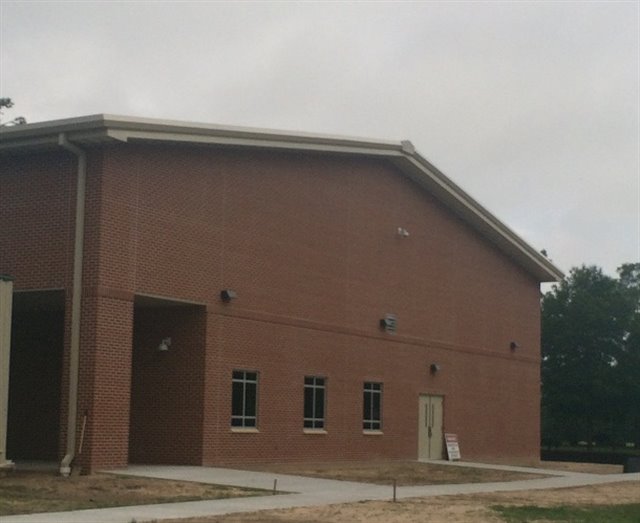

  • Live Entertainment Technology Building: Obtained a temporary certificate of occupancy the general contractor working on follow up punch list items. The installation of A/V equipment is complete. Commissioning is underway.

LSC-North Harris

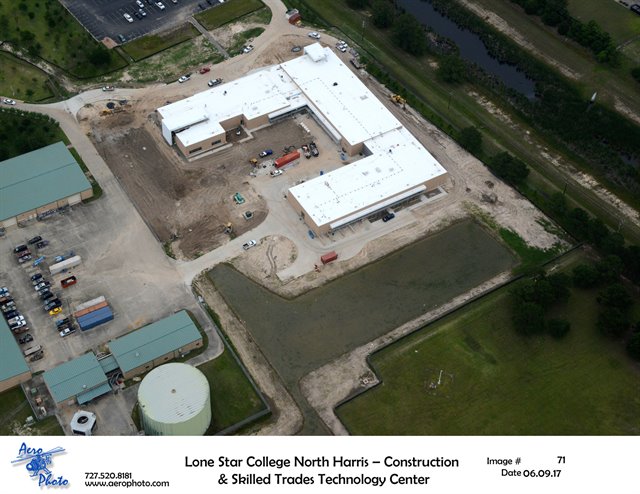

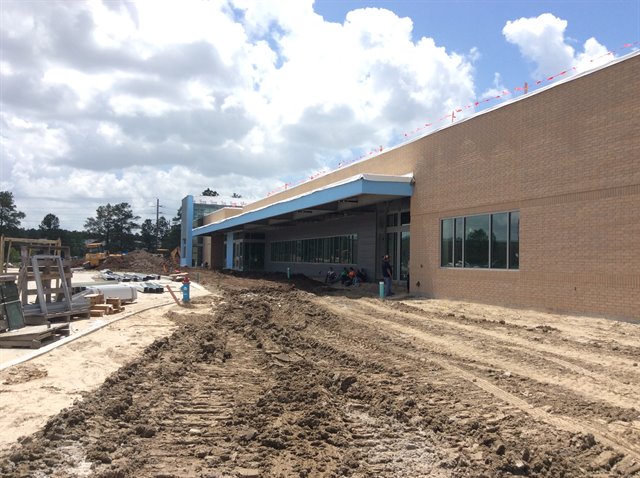

  • LSC-Construction & Skilled Trades Technology Center: Masonry, windows, and interior sheetrock nearing completion. Interior floor, ceiling and wall finishes are in progress. Final sitework (grading, sidewalks and landscape) have begun. Construction is expected to be substantially complete by early-July 2017.
LSC-Construction & Skilled Trades Technology Center -- photo courtsey JLL

  • LSC-East Aldine Satellite Center: Architectural drawings for Aldine Independent School District (“AISD”) Early College need to be completed and rebid. Following the conclusion of the bid process, a revised guaranteed maximum price (“GMP”) contract is expected to be presented to the Board of Trustees for consideration of approval in August 2017. Construction for the East Aldine Satellite Center and AISD Early College Facility is expected to be complete in early 2019.
  • Relocate Electrical Service Underground: The service cut over did not occur as planned for the week of March 13 because of the late delivery of electrical switches to the contractor. Two of three switches have arrived and been installed. The third switch is due any day and the cut over will occur in late May 2017.
  • Central Plant Renovations: Project final price negotiations have been terminated with the awarded contractor. The College is in the planning process of developing another competitive bidding event for this project. A revised expected completion timeframe is forthcoming.

LSC-Tomball

  • South Entrance Drive: Final price negotiations with the best value contractor are still ongoing. Campus personnel have been coordinating the new entrance and the SH 249 expansion projects. CenterPoint overhead and underground work is in progress.

LSC-University Park

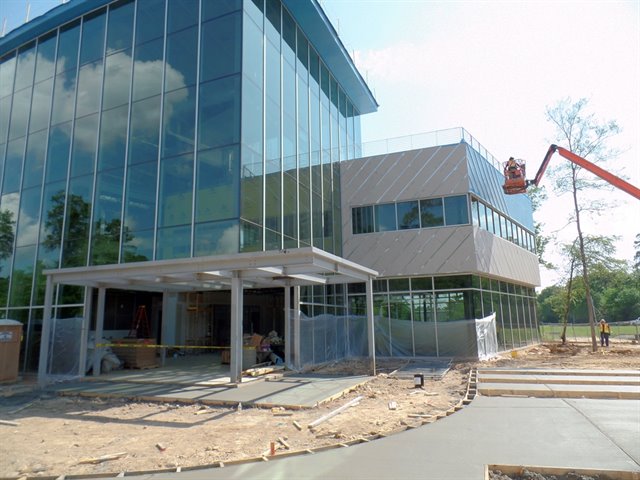

  • LSC-Science and Innovation Building: The interior and exterior are essentially complete, but construction of the domestic and sanitary water service by the local municipal utility district (“MUD”) and the installation of the geological wall exhibit area are going to delay occupancy until at least late Summer 2017.
  • Buildings 12 & 13 Entrance Canopy and Parking: The College, at the request of the Business Park Association, is in the process of contract finalization for the performance of a traffic impact study. This study is a pre-requisite to obtaining project authorization by the Business Park Association.

  • Library Remodel, Building 13 Level 8: Project final price negotiations have been terminated with the awarded contractor. The College is in the planning process of developing another competitive bidding event for this project. A revised expected completion timeframe is forthcoming.
LSC-University Park Library Remodel -- photo courtsey JLL
  • Kitchen Removal, Commons Building Level 1: Project final price negotiations have been terminated with the awarded contractor. The College is in the planning process of developing another competitive bidding event for this project. A revised expected completion timeframe is forthcoming.

LSC-System-wide Security Updates

  • Satellite center mass communication upgrades are complete. Security and mass notification upgrades at main campuses will be bid and contracted in two phases. The bid has been put on hold until further notice.

May 2017

LSC-CyFair

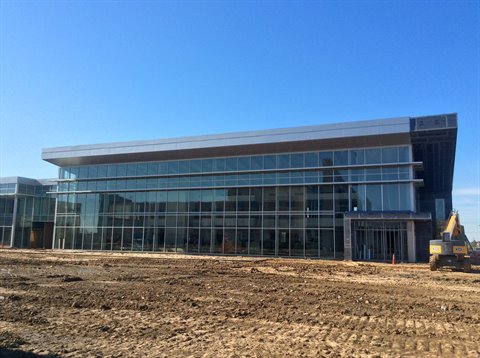

  • Instruction and Student Life Building: Metal panel installation is complete on the exterior of Area A. Permanent power is now available with painting, millwork, door hanging, ceiling tile installation nearing completion in class rooms. Audio/visual (“A/V”) installation on speaker work and support system of projectors is in progress. Elevators are now installed. Permanent gas to start up boilers and temporary air conditioning is nearing completion. Start-up and commissioning of mechanical and electrical equipment continues. Landscaping and tree planting is nearing completion. Movable furniture is on order and had to be rescheduled for delivery in mid-May. Chiller piping is now tied-in and cleaning of lines is complete. Project completion has been revised due to the permanent power delay until mid to late June 2017.
LSC-Cy Fair Instruction and Student Life Building -- photo courtesy JLL

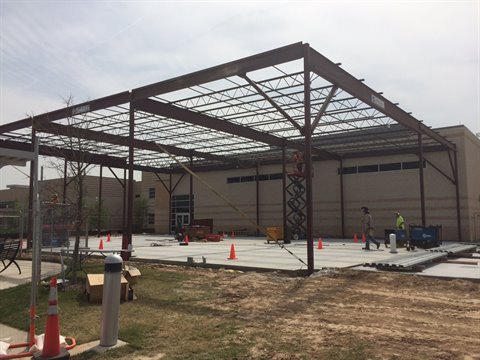

  • LSC-Cypress Center Expansion: Exterior walls are waterproofed and masonry has started. Mechanical and electrical work is progressing in both the building addition and renovated existing spaces. Furniture for the project is on order. Project is still tracking to be complete by the end of July 2017.
LSC-Cypress Center -- photo courtsey JLL
  • LSC-Westway Park Technology Center: Project contract has been approved, but final price negotiations are still ongoing. Expected completion is Spring 2018.

LSC-Kingwood

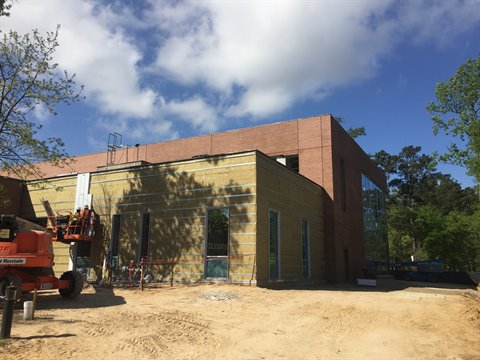

  • Student Services Center Expansion: Exterior metal panel installation is nearing completion. MEP is ready for above ceiling city inspection. Interior construction continues and guardrail installation is underway. Ceiling devices and fixtures are installed. Installation of floor tile, carpet, and wall tile is underway. Painting is in progress. Construction is expected to be complete by the end of April 2017.
LSC-Kingwood Student Services -- photo courtsey JLL

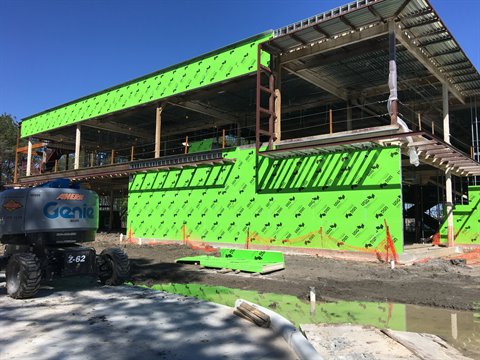

  • LSC-Process Technology Center: Exterior framing is complete, and sheathing and waterproofing continues. Roofing is underway. Level 1 interior framing continues. Wall and above-ceiling mechanical, electrical and plumbing (“MEP”) has been challenging, but is progressing. Furniture bids have been received and will be evaluated. Utility service to the site is currently underway. Construction is expected to be complete by late August 2017.
LSC-Process Technology Center -- photo courtesy JLL

LSC-Montgomery

  • Live Entertainment Technology Building: Commissioning is underway. A/V, furniture, and specialty equipment are on order.
LSC-Montgomery Live Entertainment Technology Building -- photo courtsey of JLL

LSC-North Harris

  • LSC-Construction & Skilled Trades Technology Center: MEP wall and overhead rough in, roofing and exterior wall waterproofing are complete. Masonry, windows, and interior sheetrock are in progress. The Heating, Ventilation and Air Conditioning (“HVAC”) system has been started to condition the interior space and interior finishes have begun. Construction is expected to be complete in July 2017.
LSC-Construction & Skilled Trades Technology Center -- photo courtsey of JLL
  • LSC-East Aldine Center: Architectural drawings for Aldine Independent School District (“AISD”) Early College need to be completed and rebid. Following the conclusion of the bid process, a revised guaranteed maximum price (“GMP”) contract is expected to be presented to the Board of Trustees for consideration of approval in August. Construction for the East Aldine Satellite Center and AISD Early College is expected to be completed in early 2019.
LSC-East Aldine Center -- photo courtsey of JLL
  • Relocate Electrical Service Underground: The service cut over did not occur as planned for the week of March 13 because of the late delivery of electrical switches to the contractor. Two of three switches have arrived and been installed. The third switch is due any day and the cut over will occur over two consecutive weekends. Construction is expected to be complete by the end of April 2017.
  • Central Plant Renovations: The GMP contract is in process. Construction is expected to be complete in the third quarter of 2017.

LSC-Tomball

  • South Entrance Drive: Board of Trustees approval has been received. Negotiation with the successful bidder is in progress. Campus personnel have been coordinating the new entrance and the SH 249 expansion projects.

LSC-University Park

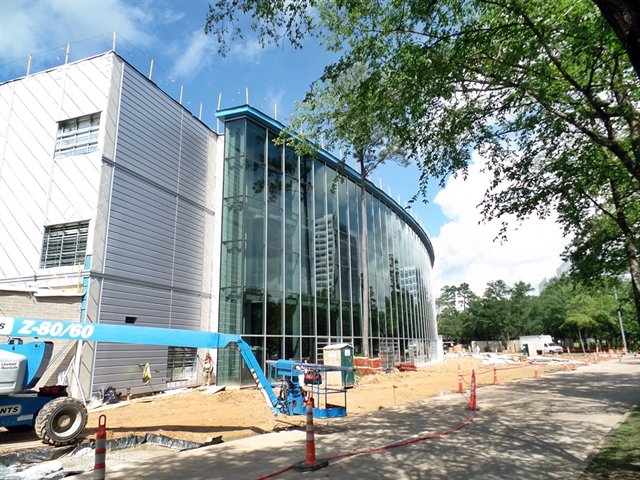

  • LSC-Science and Innovation Building: The interior and exterior are nearly complete, but delays in construction of the domestic and sanitary water service by the local municipal utility district (“MUD”) and the installation of the geological wall exhibit area are going to delay occupancy until at least late Summer 2017.
LSC-Science and Innovation Building -- photo courtsey of JLL
  • Buildings 12 & 13 Entrance Canopy and Parking: A traffic impact study has been requested from the business park association prior to them approving the project.
  • Library Remodel, Building 13 Level 8: The GMP contract has been rejected due to non-agreement on final project price. The project team is working with the architect and Purchasing to prepare the construction documents to issue a competitive sealed proposal (“CSP”). The project schedule will be adjusted to accommodate this change.
  • Kitchen Removal, Commons Building Level 1: Construction documents were issued for bid in March. Preparing the GMP contract for an anticipated submission to the Board of Trustees for consideration of approval at the June meeting. Construction is expected to be complete this summer.

LSC-System-wide Security Updates

  • Satellite center mass communication upgrades are complete. Security and mass notification upgrades at main campuses will be bid and contracted in two phases. The bid has been put on hold until further notice.

April 2017

LSC-CyFair

  • Instruction and Student Life Building: Exterior metal panel installation is in progress on Area A. Interior finishes work continues including painting, ceramic tile work in bathrooms, and light fixture installation in class rooms. Audio/visual (“A/V”) infrastructure installation is in progress. Permanent power is awaiting CenterPoint’s primary line installation. Commissioning of mechanical and electrical equipment is in progress. Surface parking is complete and final work is being done on the curbing and sidewalks. Landscaping work is underway. The Central Plant Addition interior work is finished. Furniture is on order and slated for delivery in late April. Chiller piping is now tied in and testing is progressing. Project completion is anticipated at the end of April 2017.

LSC-CyFair Instruction and Student Life Building -- photo courtesy JLL

  • LSC-Cypress Center Expansion: Structural steel erection is near completion. Mechanical and electrical infrastructure routings have been defined to service the new building addition. Exterior parking paving is complete. Furniture for the project is on order. The project is still tracking to be complete by the end of July 2017.
LSC-Cypress Center  -- photo courtesy JLL
  • LSC-Westway Park Technology Center: Project contract has been approved. Mobilization of the project is in progress. The submittal process has commenced with contractors and vendors. Primary initial focus will be on the Data Center room. Construction is expected to be complete for Spring 2018 classes.

LSC-Kingwood

  • Student Services Center Expansion: Exterior wall construction is in progress. Mechanical, Electrical and Plumbing (“MEP”) installation is nearing completion. Interior wall and finish preparation is beginning. Furniture and A/V equipment has been ordered. Construction is expected to be complete in April 2017.
LSC Kingwood Student Services Center -- photo courtesy JLL
  • LSC-Process Technology Center: Structural steel framing is complete. Level 2 concrete pour is complete. Roof decking is complete. Site paving is nearing completion. Mechanical rough-in has started. Furniture and graphics bid packages are in progress. Construction is expected to be complete in August 2017.
LSC-Process Technology Center -- photo courtesy JLL

LSC-Montgomery

  • LSC-Conroe Center: Final closeout for project is underway.
  • Live Entertainment Technology Building: Construction is complete. Commissioning and punch lists are being worked. A/V and specialty equipment are on order.

LSC-North Harris

  • LSC-Construction & Skilled Trades Technology Center: Exterior wall, framing, sheathing, and insulation are complete. MEP wall and overhead rough in, roofing and exterior wall waterproofing are in progress. Masonry, windows and interior sheetrock have begun. Construction is expected to be complete in July 2017.
  • LSC-East Aldine Center and Aldine Independent School District (“AISD”) MacArthur Early College Facility (“Facility”): Architectural drawings for the AISD Facility need to be completed and rebid. Following the conclusion of the bid process, a revised guaranteed maximum price (“GMP”) contract is expected to go before the Board in August. Construction for the East Aldine Satellite Center and AISD Facility are expected to be complete in early 2019.
  • Relocate Electrical Service Underground: Electrical underground conduit installation is complete. The service cut over is planned for the week of March 13. Constructionis expected to be complete in April 2017.
  • Central Plant Renovations: The GMP contract is in process. Construction is expected to be complete in mid-2017.

LSC-Tomball

  • South Entrance Drive: The Interview Review Committee convened to interview the bidders. Campus personnel have been coordinating the new entrance and the S.H. 249 expansion projects. Dr. Nutt publicizes weekly updates to students, faculty and staff regarding the S.H. 249 expansion and the impact it may have on their travels to and from the campus.

LSC-University Park

  • LSC-Science and Innovation Building: The interior and exterior finishes are nearing completion. Completion of the remaining work is dependent on completion of construction of the domestic and sanitary water service from the local MUD, the installation of 20 owner-supplied fume hoods and the installation of the geological wall exhibit area. Due to a few recent delays, this project is now anticipated to be complete by Summer 2017, a change from the original April completion date.
Science and Innovation Building -- photo courtesy JLL
  • Buildings 12 & 13 Entrance Canopy and Parking: A traffic impact study has been requested from the business park association prior to them approving the project. The study is currently underway.
  • Library Remodel, Building 13 Level 8: Construction documents have been bid. The furniture package is out to bid. The GMP contract is anticipated to be presented to the Board in June, but this may occur later. Construction is expected to be complete in October 2017.
  • Kitchen Removal, Commons Building Level 1: Construction documents were issued for bid in March. The GMP contract is anticipated to be presented to the Board in June. Construction is expected to be complete this summer.

LSC-System-wide Security Updates

  • Satellite Center mass communication upgrades are complete. Security and mass notification upgrades at main campuses will be bid and contracted in two phases. The bid has been put on hold until further notice.

March 2017

LSC-CyFair

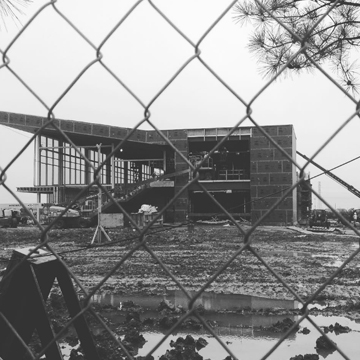

  • Instruction and Student Life Building: Exterior masonry work is nearing completion. Interior finishes are in progress with tile and toilets nearing completion. Ceiling grid installation is progressing and interior painting is fully underway. Permanent power is near completion. Overall project construction is expected to be complete in April 2017.

LSC-CyFair Instruction and Student Life Building -- photo courtesy JLL

  • LSC-Cypress Center Expansion: Construction of underground utilities, piers and slab on grade are complete. Structure is now in progress. This project is still on track to be complete in June 2017
  • LSC-Westway Park Technology Center: The CMAR contract is being recommended for consideration of approval at the March 2017 Board of Trustees meeting. Construction is expected to be complete during the Fall of 2017.

LSC-Kingwood

  • Student Services Center Expansion: Structural steel is complete. Exterior envelope is in progress. MEP rough in is nearing completion. Construction is expected to be complete in March 2017.
LSC-Kingwood Student Services Center -- photo courtsey JLL

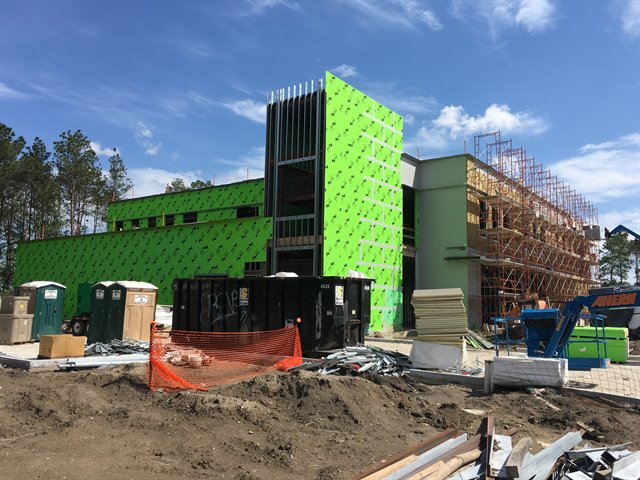

  • LSC-Process Technology Center: Structural steel erection, site utilities, and site paving are nearing completion. Furniture and Graphics bid packages are in progress. Construction is expected to be complete in August 2017.

LSC-Montgomery

  • LSC-Conroe Center: Commissioning efforts are underway. Closeout documentation is being compiled for the College.

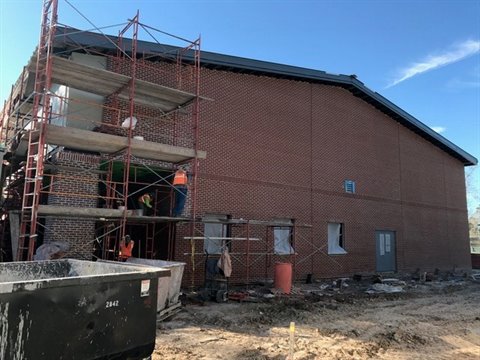

  • Live Entertainment Technology Building:Masonry is complete. HVAC and electrical equipment have been installed. Audio equipment, pipe and drapes are out for bid. Construction is expected to be complete in March 2017.
LSC- Montgomery Live Entertainment Technology Building -- photo courtsey JLL

LSC-North Harris

  • LSC-Construction & Skilled Trades Technology Center: Exterior wall, framing, sheathing, insulation and MEP wall and overhead rough in are in progress. Roofing and exterior wall waterproofing has begun. Construction is expected to be complete in July 2017.
LSC-Construction & Skilled Trades Technology Center -- photo courtsey JLL
  • LSC-East Aldine Center: Architectural drawings are complete. Meetings with the Construction Manager at Risk to discuss drawings are upcoming. Construction is expected to be complete in May 2018.
  • Relocate Electrical Service Underground: Electrical underground conduit installation is underway. Construction is expected to be complete in April 2017.
  • Central Plant Renovations: The GMP contract will be executed soon. Construction is expected to be complete in mid-2017.

LSC-Tomball

  • South Entrance Drive: Bids have been received and evaluated. It is anticipated that the project will be presented for consideration of approval at the March Board of Trustees meeting. Coordination meetings have been held with the HCTRA stakeholders regarding where the new entrance drive will tie into S. H. 249.

LSC-University Park

  • LSC-Science and Innovation Building: The exterior building finishes are nearing completion. Most interior walls and the floors and ceilings are finished. Architectural casework and lab benches are being installed. Specialty equipment continues to arrive and be integrated into the facility. This project is expected to be complete in May 2017.
Science and Innovation Building @ LSC-University Park
  • Buildings 12 & 13 Entrance Canopy and Parking: A traffic impact study has been requested from the business park association prior to them approving the project. That study is currently underway.

LSC-System-wide Security Updates

  • Satellite Center mass communication upgrades are complete. Security and mass notification upgrades at main campuses will be bid and contracted in two phases. The bid has been put on hold until further notice.

February 2017

LSC-CyFair

  • Instruction and Student Life Building: Exterior masonry work is in progress. Interior drywall is complete. Interior finishes are in progress and permanent power is near
    completion. Overall project construction is expected to be complete in April 2017.

LSC-CyFair Instruction and Student Life Building -- photo courtesy JLL

  • LSC-Cypress Center Expansion: Demolition is complete. Construction of underground utilities and piers are complete. Slab on grade is still on track for the
    first week in February. This project is still on track to be complete in June 2017.
  • LSC-Westway Park Technology Center: The CMAR contract will be presented for consideration of approval at the March 2017 Board of Trustees meeting. Construction is expected to be complete during Spring 2018.

LSC-Kingwood

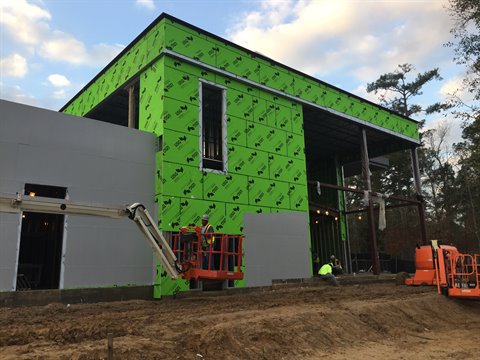

  • Student Services Center Expansion: Roofing is complete. All framing and MEP rough in is in progress. Construction is expected to be complete in March 2017.

 LSC-Kingwood Student Services Center Expansion -- photo courtsey JLL

  • LSC-Process Technology Center: Structural steel erection, site utilities, and site paving are in progress. Construction is expected to be complete in August 2017.

LSC-Montgomery

  • LSC-Conroe Center: Construction is substantially complete. Installation of owner furnished equipment is underway. Punch list items are being addressed and final preparations for the Grand Opening Event on January 19, 2017 are being completed.
  • Live Entertainment Technology Building Expansion: Steel erection and exterior weather proofing is complete. Masonry has begun. Installation of interior utilities and stud walls are underway. Construction is expected to be complete in March 2017.

 LSC-Montgomery Live Entertainment Technology Building -- photo courtsey JLL

LSC-North Harris

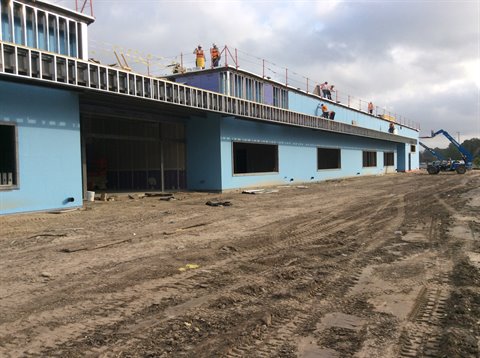

  • LSC-Construction & Skilled Trades Technology Center: Structural steel and roof decking is complete, and the exterior wall framing, and MEP wall and overhead rough in are in progress. Construction is expected to be complete in July 2017.

 LSC-North Harris Construction & Skilled Trades Technology Center -- photo courtsey JLL

  • LSC-East Aldine Center: It is anticipated that the GMP will be presented for consideration of approval at the April 2017 Board of Trustees meeting. Construction is expected to be complete in May 2018.
  • Relocate Electrical Service Underground: Electrical underground conduit is underway. Construction is expected to be complete in April 2017.
  • Central Plant Renovations: The GMP contract is waiting on LSC execution. Construction is expected to be complete in mid-2017.

LSC-Tomball

  • LSC-Health Science Building 3rd Floor Buildout: The project has been completed and an open house was conducted on January 12.

LSC-Tomball Health Science Building -- photo courtsey JLL

  • South Entrance Drive: Bids have been received and evaluated. It is anticipated that the project will be presented for consideration of approval at the March Board of Trustees meeting.

LSC-University Park

  • LSC-Science and Innovation Building: The building is enclosed. Development of interior utilities and partitioning continue. Specialty equipment is arriving and being integrated into the construction. This project is expected to be complete in May 2017.
  • Building 12 & 13 Entrance Canopy and Parking: The work site has been cleared and layout is underway for the underground utilities.

LSC-System-wide Security Updates

  • Satellite Center mass communication upgrades are complete. Security and mass notification upgrades at main campuses will be bid and contracted in two phases. The bid has been put on hold until further notice.

December 2016

LSC-CyFair

  • LSC-Cypress Center Expansion: Construction will begin in December and is expected to be complete in June 2017.
  • LSC-Westway Park Technology Center: The GMP is being presented for consideration of approval at the December 2016 Board of Trustees meeting. Construction is expected to be complete in summer 2017.

LSC-Kingwood

  • Student Services Center Expansion: Structural steel erection is complete; roofing is in progress. Construction is expected to be complete in February 2017.
  • LSC-Process Technology Center: Foundation, underground site utilities, and site paving are in progress. Construction is expected to be complete in August 2017.

LSC-Montgomery

  • LSC-Conroe Center: Commissioning and utility connections for equipment are in progress. Construction is expected to be complete in January 2017.
  • Live Entertainment Technology Building: Building slab is complete; metal building erection is in progress. Construction is expected to be complete in March 2017.

LSC-North Harris

  • LSC-Construction & Skilled Trades Technology Center: Site utilities and paving are complete. Structural steel, roof decking, exterior wall framing, and interior piping are in progress. Construction is expected to be complete in July 2017.
  • LSC-East Aldine Center: It is anticipated that the GMP will be presented for consideration of approval at the April 2017 Board of Trustees meeting. Construction is expected to be complete in May 2018.
  • Relocate Electrical Service Underground: The Contractor is mobilizing. Construction is expected to be complete in April 2017.
  • Central Plant Renovations: The GMP contract is being presented for consideration of approval at the December 2016 Board of Trustees meeting. Construction is expected to be complete in May 2017.

LSC-Tomball

  • LSC-Health Science Building - 3rd Floor Buildout: Buildout of Surgical Tech area is expected to be complete in December 2016.
  • South Entrance Drive: Bids have been received and are being evaluated. It is anticipated that the project will be presented for consideration of approval at the February 2017 Board of Trustees meeting. Construction is expected to be complete in fall 2017.

LSC-University Park

  • LSC-Science and Innovation Building: Roofing and exterior sheathing are complete. Erection of the front glass curtainwall, interior overhead MEP work, and partition framing are in progress. Construction is expected to be complete in May 2017.

  • Building 12 & 13 Entrance Canopy and Parking: Construction will begin in December and is scheduled for an April 2017 completion.

LSC-System-wide Security Updates

  • Satellite Center mass communication upgrades are complete. Security and mass notification upgrades at main campuses will be bid and contracted in two phases. They will be presented for consideration of approval at the February and March 2017 Board of Trustees meetings, with a fall 2017 completion.

November 2016

LSC-CyFair

  •  Instruction and Student Life Building: The roofing, exterior sheathing, windows, and mechanical/electrical/plumbing rough-ins are complete. Glass curtain wall, brick, and interior drywall are in progress. Overall project construction is expected to be complete in March 2017.

  • LSC-Cypress Center Expansion: Construction will begin in December and is expected to be complete in summer 2017.
  • LSC-Westway Park Technology Center: The GMP will be presented for consideration of approval at the December 2016 Board of Trustees meeting. Construction is expected to be complete in summer 2017.

LSC-Kingwood

  • Student Services Center Expansion: Structural steel is in progress. Construction is expected to be complete in February 2017.
  • LSC-Process Technology Center: Foundation work is in progress. Construction is expected to be complete in August 2017.

LSC-Montgomery

  • LSC-Conroe Satellite Center: Mechanical and electrical equipment, as well as stairs and sidewalks, are complete. Interior walls are complete and finish work is in progress. Construction is expected to be complete in January 2017.
  • Live Entertainment Technology Building: Underground utility installation nearing completion. The building slab will be placed in early November. Construction is expected to be complete in March 2017.

LSC-North Harris

  • LSC-Construction & Skilled Trades Technology Center: Foundation and detention pond are complete, while building slab and site utilities are in progress. Construction is expected to be complete in July 2017.
  • LSC-East Aldine Center: The construction documents have been completed and negotiations with Aldine ISD on the associated Interlocal Agreement are in progress.
  • Relocate Electrical Service Underground: The GMP is being presented for consideration of approval at the November 2016 Board of Trustees meeting. Construction is expected to be complete in April 2017.
  • Central Plant Renovations: Bidding is in progress. It is anticipated that the GMP will be presented for approval at the December 2016 Board of Trustees meeting. Construction is expected to be complete in May 2017.

LSC-Tomball

  • LSC-Health Science Building - 3rd Floor Buildout: Surgical equipment is being installed on the second floor, with completion anticipated in November 2016.
  • South Entrance Drive: Bidding is in progress. It is anticipated that the GMP will be presented for consideration of approval at the February 2017 Board of Trustees meeting, with a fall 2017 construction completion.

LSC-University Park

  • LSC-Science and Innovation Building: Steel erection and floor slabs are complete. Roofing, exterior walls, and mechanical, electrical, and plumbing work are in progress. Construction is expected to be complete in May 2017.
  • Building 12 & 13 Entrance Canopy and Parking: Construction will begin in November and is scheduled for a March 2017 completion.

October 2016

LSC-CyFair

  • Instruction and Student Life Building: The roof deck is complete, and the exterior wall and glass are in progress. Overall project construction is expected to be complete in March 2017.
  • LSC-Westway Park Technology Center: Subcontractor bidding is in progress. It is anticipated that the GMP will be presented for consideration of approval at the November 2016 Board of Trustees meeting. Construction is expected to be complete in July 2017.

LSC-Kingwood

  • Student Services Center Expansion: Foundation work is in progress. Construction is expected to be complete in January 2017.
  • LSC-Process Technology Center: Tree removal and site clearing is in progress. The groundbreaking ceremony was held October 4, 2016. Construction is expected to be complete in August 2017.

LSC-Montgomery

  • LSC-Conroe Center: Roofing and brick installation is nearing completion. Utility installation and interior construction are in progress. Construction is expected to be complete in January 2017.
  • Live Entertainment Technology Building: Existing utility surveying is complete, and the building pad is in progress. Construction is expected to be complete in March 2017.

LSC-North Harris

  • LSC-Construction & Skilled Trades Technology Center: Foundation and building slab are in progress. Construction is expected to be complete in July 2017.
  • LSC-East Aldine Center: Construction documents are complete and it is anticipated that the GMP will be presented for consideration of approval at the February 2017 Board of Trustees meeting. Construction is expected to be complete in March 2018.
  • Relocate Electrical Service Underground: Construction documents are being bid and the permit has been received. It is anticipated that the GMP will be presented for approval at the November 2016 Board of Trustees meeting. Construction is expected to be complete in April 2017.

LSC-Tomball

  • LSC-Health Science Building - 3rd Floor Buildout: Third floor construction is complete. Associated work on second floor is in progress and is expected to be complete in November 2016.

LSC-University Park

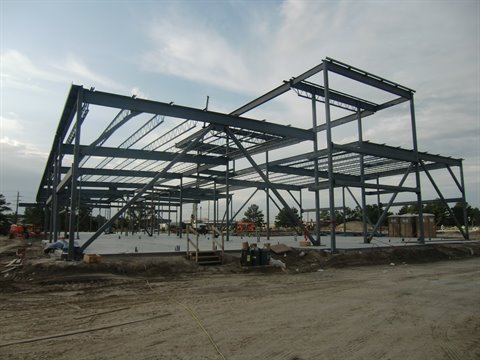

  • LSC-Science and Innovation Center: Steel erection is nearing completion. Construction is expected to be complete in May 2017.

September 2016

LSC-CyFair

  • Instruction and Student Life Building: HVAC duct installation is nearing completion and the exterior wall and roof deck are in progress. CASA renovations and south parking lot were complete for the start of the fall semester. Overall project construction is expected to be complete in March 2017.
  • LSC-Westway Park Technology Center: Construction documents are complete. It is anticipated that the GMP will be presented for consideration of approval at the November 2016 Board of Trustees meeting. Construction is expected to be complete in July 2017.

LSC-Kingwood

  • Student Services Center Expansion: Earthwork and building pad are complete. Construction is expected to be complete in January 2017.
  • LSC-Process Technology Center: Site clearing is in progress. Construction is expected to be complete in August 2017.

LSC-Montgomery

  • LSC-Conroe Center: Exterior walls are complete. Roofing and interior construction are in progress. Construction is expected to be complete in January 2017.
  • Live Entertainment Technology Building: Site clearing is complete. Earthwork is in progress. Construction is expected to be complete in March 2017.
  • LSC-Magnolia Center: Site purchase is being negotiated.

LSC-North Harris

  • LSC-Construction & Skilled Trades Technology Center: Sitework has begun. Construction is expected to be complete in July 2017.
  • LSC-East Aldine Center: Construction documents are complete. It is anticipated that the GMP will be presented for consideration of approval at the November 2016 Board of Trustees meeting. Construction is expected to be complete in December 2017.
  • LSC-Transportation and Logistics Institute: Site purchase is being negotiated.
  • Relocate Electrical Service Underground: Construction documents are in progress and it is anticipated that the GMP will be presented for approval at the November 2016 Board of Trustees meeting. Construction is expected to be complete in March 2017.

LSC-Tomball

  • LSC-Health Science Building - 3rd Floor Buildout: Construction was complete for the start of the fall semester.

LSC-University Park

  • LSC-Science and Innovation Center: Steel erection is in progress. Construction is expected to be complete in May 2017.

August 2016

LSC-CyFair

  •  Instruction and Student Life Building: Building slab and second floor have been placed and structural steel erection is complete. Masonry walls on Central Plant are complete. Construction continues on schedule and is expected to be complete in March 2017.
  • LSC-Cypress Center Expansion: Construction is scheduled to begin in November 2016 simultaneous with the Westway Park Technology Center and be complete in May 2017.
  • LSC-Westway Park Technology Center: Construction documents are in progress. It is anticipated that the GMP will be presented for consideration of approval at the November 2016 Board of Trustees meeting. Construction is expected to be complete in July 2017.

LSC-Kingwood

  • Student Services Center Expansion: Earthwork and building pad construction are in progress.
  • LSC-Process Technology Center: The GMP was approved at the June 2016 Board of Trustees meeting and the contract is being finalized.

LSC-Montgomery

  • LSC-Conroe Satellite Center: Building foundation is complete and exterior walls are in progress. Construction is expected to be complete in January 2017.
  • Live Entertainment Technology Building: The GMP was approved at the June 2016 Board of Trustees meeting and the Contractor has mobilized. Construction is expected to be complete in March 2017.
  • LSC-Magnolia Center: Site alternatives continue to be evaluated.

LSC-North Harris

  • LSC-Construction & Skilled Trades Technology Center: The GMP was approved at the June 2016 Board of Trustees meeting. Construction is expected to be complete in July 2017.
  • LSC-East Aldine Center: The Aldine ISD Early College Facility Design Development documents are in progress and it is anticipated that the GMP will be presented for consideration of approval at the November 2016 Board of Trustees meeting. Construction of both projects is expected to be complete in November 2017.
  • LSC-Transportation and Logistics Institute: Site purchase alternatives continue to be evaluated.
  • Relocate Electrical Service Underground: Design Development is in progress and it is anticipated that the GMP will be presented for approval at the November 2016 Board of Trustees meeting. Construction is expected to be complete in March 2017.

LSC-Tomball

  • LSC-Health Science Building - 3rd Floor Buildout: Construction is progressing on schedule and is expected to be complete in August 2016.

LSC-University Park

  • LSC-Science and Innovation Center: Building slab is nearing completion. Construction is expected to be complete in May 2017.
  • Classroom Renovations in Building 12, Level 7: Construction is progressing on schedule and is expected to be complete in August 2016.

June 2016

LSC-CyFair

  • Instruction and Student Life Building: Building slab has been placed and structural steel erection is in progress. Masonry walls on Central Plant are in progress. Construction is expected to be complete in March 2017.
  • LSC-Cypress Center Expansion: The Guaranteed Maximum Price (“GMP”) is being presented for consideration of approval at the June 2016 Board of Trustees meeting. Construction is expected to be complete in March 2017.
  • LSC-Westway Park Technology Center: Construction documents are in progress. It is anticipated that the GMP will be presented for consideration of approval at the September 2016 Board of Trustees meeting. Construction is expected to be complete in May 2017.

LSC-Kingwood

  • Student Services Center Expansion: Site utilities are in progress. Construction is expected to be complete in January 2017.
  • LSC-Process Technology Center: The GMP is being presented for consideration of approval at the June 2016 Board of Trustees meeting. Construction is expected to be complete in July 2017.

LSC-Montgomery

  • LSC-Conroe Center: Building foundation is in progress. Construction is expected to be complete in January 2017.
  • Live Entertainment Technology Building: The GMP is being presented for consideration of approval at the June 2016 Board of Trustees meeting. Construction is expected to be complete
    in March 2017.
  • LSC-Magnolia Center: Negotiations on a potential land tract are underway.

LSC-North Harris

  • LSC-Construction and Skilled Trades Technology Center: The GMP is being presented for approval at the June 2016 Board of Trustees meeting. Construction is expected to be complete in June 2017.
  • LSC-East Aldine Center: The Aldine ISD Early College Facility Design Development documents are in progress and it is anticipated that the GMP will be presented for consideration of approval at the October 2016 Board of Trustees meeting. Construction of both projects is expected to be complete in November 2017.
  • LSC-Transportation and Logistics Institute: Negotiations on a potential land tract are underway.
  • Relocate Electrical Service Underground: Design Development documents are in progress and it is anticipated that the GMP will be presented for approval at the September 2016 Board of Trustees meeting. Construction is expected to be complete in January 2017.

LSC-Tomball

  • LSC-Health Science Building - 3rd Floor Build out: Interior partitions and mechanical, electrical, and plumbing overhead work in progress. Construction is expected to be complete in August 2016.

LSC-University Park

  • Science and Innovation Center: Underground utility installation is in progress. Construction is expected to be complete in May 2017.
  • Workforce Assessment Center: Construction documents are in progress. It is anticipated that the GMP will be presented for consideration of approval at the September 2016 Board of Trustees meeting. Construction of this interior renovation project is expected to be complete in December 2016.

May 2016

LSC-CyFair

Construction continues on the new Instructional/Student Life building at Lone Star College-CyFair. Constructed on 15 acres, the new building will not only house new faculty and dean suites, but instructional and student spaces, 750 parking spaces for students and staff and a three-level Learning Garden.

April 2016

LSC-University Park

The groundbreaking for LSC-University Park’s new Center for Science & Innovation begins at 10 a.m. on Thursday, April 28, near the intersection of University Park Campus Drive and Compaq Center Drive West.

This innovative facility will provide students with a state-of-the-art learning environment and will encourage more students to consider STEM careers.
Designed by Kirksey Architecture, the three-story structure will have 12 science labs for chemistry and biology, an “innovation space” with a tutoring area and a sprawling geology teaching wall. In addition, students and visitors alike can view celestial objects through a variety of telescopes from the observation deck atop the Center of Science & Innovation.

LSC-University Park President Shah Ardalan said the 50,000-square-foot building, due to open in Fall 2017, will help the College meet the academic needs of its rapidly growing population.

March 2016

LSC-CyFair

LSC-CyFair broke ground on its new instructional building March 7. The 75,000 square foot facility will be built between the center for academic affairs and student affairs building and house 16 classrooms, 3 multipurpose class rooms, 4 computer classrooms, 2 prototype computer classroom and 1 open computer lab.

The building is expected to open in spring 2017 and feature a 3 level landscaped outdoor space, known as the learning garden.

February 2016

LSC-University Park

LSC-University Park plans to break ground on its new 50,000 square foot science building in March 2016. The LSCS Board of Trustees approved the pending design during its February 2016 meeting.

The three-story building will house 12 science labs and be equipped with the latest technology and is expected to be completed for the start of fall 2017 classes.

LSC-CyFair

The LSC-Westway Park Technology Center location has been finalized. The center will be at 5060 Westway Park Boulevard. LSC will initially build out 50,000 square foot of the 130,000 square foot facility which is expected to open late spring 2017.

January 2016

LSC-Kingwood

The design development of the LSC-Process Technology Center has been completed. The 50,000 square foot center is located on 8.3 acres in Generation Park on Lockwood Drive across from Summer Creek High School. The facility is slated to open in fall 2017. Until that time, LSC-Kingwood will start the Process Technology Associate of Applied Science degree in January 2017 at the LSC-Atascocita Center.
